Setting Test Parameters
The tester needs to power on the testing instrument and locate the interface or menu for parameter - setting. Once the parameter - setting interface is found, the tester should set the parameters one by one according to the test requirements. First is the setting of the test current. The magnitude of the test current depends on the rated current of the GIS equipment and the test purpose. The tester must select an appropriate current value based on the test requirements and ensure that the testing instrument can stably output this current. When setting the current, attention should also be paid to the accuracy and stability of the current output to guarantee the accuracy of the test results.
Besides the test current, the test duration is also a crucial parameter. The length of the test duration depends on the test requirements and the characteristics of the GIS equipment. The tester needs to set an appropriate test duration according to the test requirements and ensure that the testing instrument can accurately time it. During the test, the tester should also pay attention to the start and end times of the test to ensure the integrity and accuracy of the testing process.
In addition, according to the test requirements, other parameters such as test frequency and waveform may need to be set. The setting of these parameters also needs to be selected and adjusted based on the test requirements and the characteristics of the GIS equipment.
Initiating the Test
After the preparatory work is completed, the tester initiates the testing instrument according to the predetermined operation procedure. During the startup process, the instrument will perform a self - check. After confirming that all functions are normal, the tester needs to set the test parameters, including the target current value and test duration.
The testing instrument will start sending current according to the set parameters. The current will be precisely controlled and flow through the grounding loop. The grounding loop is an essential part of the electrical system, which connects the metal casing or other conductive parts of the electrical equipment to the ground to ensure the safety of the equipment and personnel.
While the current is flowing through the grounding loop, the testing instrument will use advanced measurement techniques to monitor and record the magnitude of the loop resistance in real - time. The loop resistance is a vital indicator reflecting the performance of the grounding loop. Its magnitude directly affects the operational safety of the electrical equipment and the personal safety of personnel. Therefore, accurate measurement of the loop resistance is a very critical step in the test.
During the test, the tester will closely monitor the display and data changes of the testing instrument to promptly detect and handle any possible abnormal situations. Meanwhile, they will also conduct data analysis based on the test results to evaluate whether the performance of the grounding loop meets the requirements and formulate corresponding improvement measures accordingly.
Recording Test Results
Testers are required to record in detail basic test information, test parameters, test results, the test environment, and remarks. This facilitates a comprehensive understanding of the equipment's performance status and provides robust support for subsequent maintenance and improvement.
Analysis and Handling of Test Results
Based on the test results, the installation quality and loop integrity of GIS equipment can be evaluated. If the test results exceed the specified range, it indicates that the equipment has defects such as poor contact, necessitating further inspection and handling. Additionally, the grounding performance and connection quality of the equipment can be assessed according to the test results, providing a basis for equipment maintenance and overhaul.
Precautions

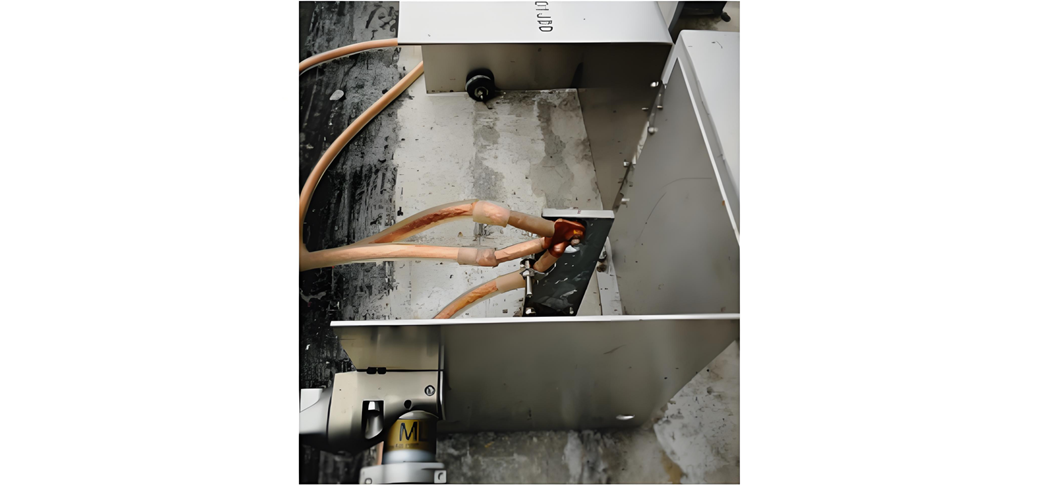

The connections between the test leads, the circuit breaker terminal block, and the tester should be tight and secure to ensure that the test current can flow smoothly through the grounding loop and accurate resistance values can be obtained. The test leads should not be tangled or disorganized but rather arranged in a simple and orderly manner to prevent interference and short - circuits between the leads, thereby ensuring the accuracy and safety of the test. Testers can sort and categorize the test leads in an orderly fashion before the test for easier operation and management during the test.
When testing three - phase electrical equipment, ensuring the basic balance of three - phase data is of utmost importance. Three - phase balance means that the three - phase currents, voltages, or other relevant parameters are approximately equal in value, which is fundamental to the normal operation of electrical equipment. Therefore, when a significant deviation in one - phase data is detected, even if the deviation is still within the acceptable range, testers should immediately stop the test and carefully check the wiring.
First, check whether the connection between the test leads and the equipment terminal block is firm and reliable, and whether there is any looseness or poor contact. If problems are found, immediate repairs should be carried out to ensure a tight and reliable connection. Also, check the internal wiring of the equipment, including inspecting components such as cables, busbars, and connectors inside the equipment for any damage, aging, or incorrect connections.
If such issues are detected, they should be promptly replaced or repaired to ensure normal and reliable internal electrical connections of the equipment. After eliminating wiring problems, if the deviation in one - phase data remains significant, it may be necessary to further inspect other parts of the equipment, such as the power supply, load, and control system, as problems in these parts can also cause abnormal one - phase data. By gradually troubleshooting and fixing these issues, the basic balance of three - phase data can be ensured, guaranteeing the normal operation of the electrical equipment.
To ensure the safe conduct of testing or maintenance work, when a current transformer (TA) is inserted into the measuring loop, the secondary winding of the TA must be short - circuited. Short - circuit operation is typically achieved by connecting a short - circuit link or short - circuit wire, which ensures that the current in the secondary winding can flow, thereby avoiding the generation of high voltage.
Conclusion
Long - distance loop resistance testing for GIS is one of the important means to ensure the safe and stable operation of GIS equipment. Through this testing, the grounding performance and connection quality of the equipment can be reflected, potential safety hazards can be detected and prevented, and the operating status and performance of the equipment can be evaluated.
In practical applications, it is necessary to strictly follow the testing methods and procedures and pay attention to relevant safety items and precautions. Through scientific testing and analysis, strong support can be provided for the preventive maintenance and fault diagnosis of GIS equipment, ensuring the safe and stable operation of the power system.
